SKI Project Update 8.16.19

STEP

This week the contractor completed 5 house connections to the Public Sewer System on Allegany and Oregon Road.  Five STEP tanks were installed by the contractor this week on Allegany Road.  Five STEP pump assemblies were installed to previously installed BIO tubes in addition to 161LF of 4” gravity sewer line installed to the individual homes.  The contractor completed 6 septic tank abandonments.  Three control panels were placed this week by the contractor along with the installation of 887LF of 1″ electrical conduit and 1″ pressure sewer line.   The contractor continues with daily yard stabilizations and restorations.  Next week, the contractor will continue with 1″ drill shots, existing and priority list house connections.  The contractor will update road signs for upcoming house connection locations.  County staff has performed 588 pre- construction meetings and acquired 756 easements to date.

  • County staff has performed 5 post-construction meetings to date.

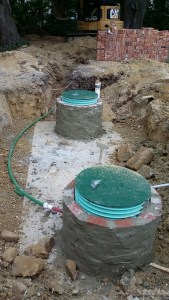

  • The contractor has installed 492 STEP tanks to date.
  • The contractor has connected 121 houses to the public sewer system to date.



1d5599ed-95fb-4d76-8972-164ac8c02da342f883e7-416e-40c9-b3c7-0f4ed746735f

%d bloggers like this:
